About

HDPE Geomembrane Installation Process: 8 Critical Steps from Subgrade Preparation to Final Acceptance

2026-09-26

📅 26 September 2026  ·  ✍️ Jwell Technical Team — Geomembrane Extrusion Engineering  ·  ⏱️ ~15 min read

HDPE geomembrane (high-density polyethylene geomembrane) is the workhorse anti-seepage material for landfills, wastewater treatment lagoons, artificial lakes, aquaculture ponds, mine tailings facilities, chemical containment and hydraulic engineering.

For any containment project, the material properties of the HDPE geomembrane itself are only the foundation. Subgrade quality, panel deployment, thermal welding, detail treatment and seam testing have an equally direct impact on the final anti-seepage performance.

HDPE geomembrane installation therefore follows the sequence:

Subgrade acceptance → Material delivery & inspection → Field deployment → Detail treatment → Welding → Seam testing → Repair & re-testing → Protective cover construction

…with specific construction parameters governed by the project design documents, applicable construction specifications and works classification. This guide walks through the 8 critical steps from site preparation to final acceptance, written for contractors, EPC firms, supervisors, procurement engineers and asset owners.Standards note: In China, HDPE geomembrane products are governed by GB/T 17643-2025 (Geosynthetics — Polyethylene geomembrane). Installation must additionally follow the project design documents and the applicable water conservancy, municipal, environmental, transport or building codes. International projects commonly reference GRI-GM13 (material), GRI-GM19 (seam QA) and ASTM D6392 (seam peel/shear testing). Always defer to the governing project specification.

1. Why HDPE Geomembrane for Containment Works?

HDPE geomembrane is produced from polyethylene resin with carbon black, antioxidants, anti-aging agents and UV stabilizers, by flat-die extrusion, cast or blown-film processes. In service it delivers four properties that make it the default liner choice:

1.1 Very low permeability

HDPE has an extremely low liquid permeation rate and functions as a continuous barrier separating water, wastewater, leachate or other liquid media from the environment.

1.2 Chemical resistance

HDPE tolerates a wide range of acids, alkalis, salts and industrial chemical media — the reason it dominates wastewater, mining, chemical and solid-waste containment. Chemical compatibility must always be verified against the actual medium, concentration, temperature and exposure duration.

1.3 Flexibility

Unlike rigid barrier materials, HDPE geomembrane accommodates a degree of subgrade deformation and differential settlement, making it suitable for lagoon basins, slopes and landfill geometries.

1.4 Fusion-welded continuous barrier

HDPE sheets are joined by hot-wedge or extrusion fusion welding. With correctly controlled temperature, pressure and speed, seams become a homogeneous continuation of the liner — no adhesive, no mechanical seam. This is why material quality and welding quality must be controlled together.

2. Where HDPE Geomembrane Is Used

Environmental & solid waste

Municipal landfills · leachate treatment ponds · wastewater treatment lagoons · industrial effluent ponds · hazardous waste facilities · equalization basins · lined storage tanks

Hydraulic & water environment

Reservoir lining · water storage ponds · river-channel seepage control · artificial lakes · canals · dam and levee anti-seepage · slope lining

Mining

Tailings storage facilities · heap-leach pads · wash ponds · settling ponds · leachate ponds · process solution containment

Agriculture & aquaculture

Fish ponds · shrimp ponds · storage reservoirs · irrigation ponds · biogas digesters · oxidation ponds

Petrochemical & industrial

Chemical storage basins · reaction ponds · settling ponds · tank-farm secondary containment · industrial wastewater · secondary containment liners

Municipal & building works

Underground works seepage control · metro construction · buried water tanks · roof water features · landscape water bodies · basement waterproofing isolation

Different applications impose different requirements on thickness, width, resin, environmental resistance and welding method — which is why liner specifications should be fixed against the final application at the production stage.

3. The 8 Critical Steps of HDPE Geomembrane Installation

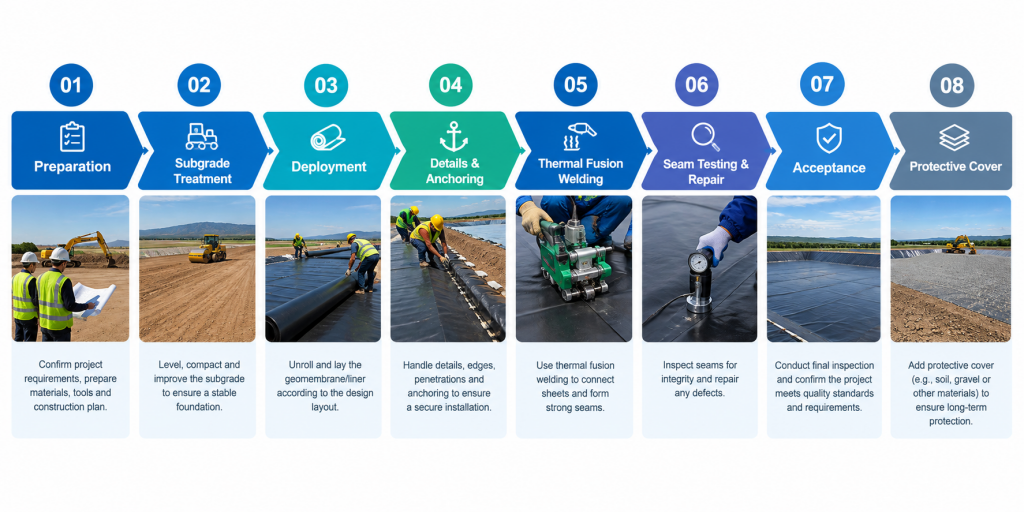

01 Preparation → 02 Subgrade treatment → 03 Deployment → 04 Details & anchoring → 05 Thermal fusion welding → 06 Seam testing & repair → 07 Acceptance → 08 Protective cover

Each step is inspected and accepted before the next begins — this sequencing is the single cheapest insurance against rework and leakage.

4. Step 1 — Construction Preparation

4.1 Master the design documents

Complete drawing review and technical disclosure before mobilizing. Confirm: liner specification and thickness · deployment extent · anchoring method · overlap orientation · seam layout · pipe penetrations · inside/outside corners · movement-joint treatment · protective cover structure · drainage and diversion systems. On large projects, produce detailed panel layout drawings from site dimensions.

4.2 Plan the panel layout

Run a nesting analysis across the basin floor, slopes and details before cutting anything. Good layout:

  • Reduces field cutting
  • Reduces total seam length
  • Reduces material waste
  • Reduces the number of complex details
  • Raises installation productivity

For large landfills, reservoirs and tailings facilities, establish a full panel-numbering and seam-numbering system before deployment.

4.3 Mobilize the right equipment

  • Automatic double-track hot-wedge welder
  • Extrusion welder (hand-held)
  • Hot-air gun
  • Vacuum box test equipment
  • Air pressure test equipment
  • Spark test equipment
  • Tensile test equipment (field destructive testing)
  • Temperature instruments
  • Cleaning and repair tools

5. Step 2 — Subgrade Preparation

The subgrade is one of the most important quality-control gates in the whole installation. Sharp stones, concrete rubble, roots or visible differential settlement under the liner create concentrated stress points — the classic cause of puncture and leakage.

Before deployment, inspect and clear the subgrade to satisfy:

  • Surface smooth and compacted
  • No standing water
  • No sharp stones
  • No roots, rubble or debris
  • No protrusions capable of puncturing the liner
  • Smooth transitions at inside and outside corners
  • Slopes and basin floor at design elevation and gradient

Where a sand bedding or other cushion layer is specified, construct it per the design documents. After subgrade acceptance, keep personnel and machinery off the finished surface.

6. Step 3 — HDPE Geomembrane Deployment

6.1 Choose the weather window

Deployment and welding need suitable temperature, wind and humidity. Avoid: high wind · rain or snow · wet membrane surface · extreme heat · extreme cold. The practical temperature window is set by the membrane grade, welder type, project specification and field trial-weld results.

6.2 Control deployment tension

Lay panels naturally flat against the subgrade — never stretch the liner taut, never leave it bridging. Correct slack accommodates thermal expansion/contraction and subgrade movement during welding and long-term service.

6.3 Manage wrinkles

Adjust panel position continuously to eliminate irregular wrinkles. Focus inspection on slopes, corners, pipe penetrations, anchorage zones and panel intersections.

6.4 Prevent wind uplift

HDPE panels are large in area and light in weight — wind is a real hazard during deployment. Ballast with sandbags or other non-damaging temporary loads.

7. Step 4 — Detail Treatment and Anchoring

Complex details are where liner systems are won or lost.

7.1 Inside and outside corners

Cut and reinforce per design. In stress-concentration zones, apply dedicated reinforcement patches, welded reliably to the parent liner.

7.2 Pipe penetrations

The archetypal difficult detail. Fabricate purpose-made boots or patches to suit the pipe diameter and node structure, joined by fusion welding, extrusion welding or mechanical fixation. For HDPE pipes, compatible HDPE connection systems may be used per design.

7.3 Anchoring methods

  • Anchor trench: embed the liner to the specified depth, backfill and compact.
  • Mechanical battens: at connections to rigid concrete structures, fix with pressure battens, bolts and sealing compounds.
  • Embedded inserts: for special structures, cast dedicated HDPE embedments into the concrete at pouring stage, then fusion-weld or mechanically connect the liner.

Anchor dimensions, embedment depth and connection structure must follow the project design documents — a one-size-fits-all detail is never acceptable.

8. Step 5 — Thermal Fusion Welding

Welding is the core operation of the installation. The common methods:

  • Double-track hot-wedge welding — long field seams, high productivity, leaves an inflation channel for air pressure testing
  • Extrusion welding — patches, corners, penetrations and complex details
  • Hot-air welding — auxiliary and temporary fixation

8.1 Trial welding is mandatory before production welding

Never run long production seams off "experience" parameters. Trial-weld against the actual: membrane thickness · HDPE resin behavior · ambient temperature · wind · membrane surface condition · welder model. The trial establishes the working combination of welding temperature + travel speed + pressure/clamping, verified by seam quality testing.

8.2 Clean the seam zone

The overlap must be clean and dry. Remove dust, grit, moisture, oil and other contamination. If the surface is damp, dry it before welding.

8.3 Control welding quality in real time

During automatic welding, monitor continuously for: seam continuity · stable weld width · welder tracking on the seam line · no excessive thermal damage · no skipped weld · no intermittent (jump) welding · no cold (unfused) weld · no burn-through.

Machine parameters are not "set once, run all day." When ambient temperature, wind or membrane condition changes materially, re-trial and re-adjust.

9. Step 6 — Seam Testing and Repair

9.1 Non-destructive testing

Air pressure testing (double-track wedge seams)

Pressurize the inflation channel between the two weld tracks to the specified pressure and monitor the decay. Pressure behavior reveals any through-going discontinuity in the seam.

Vacuum box testing

For extrusion welds, patches and complex details: apply soap solution over the seam, place the vacuum box, and observe. Continuous bubbling marks a defect for repair.

Spark testing

For special structures or where the design requires it, spark testing detects potential through-defects. Test voltage, dwell time and equipment must follow the applicable method and project specification.

9.2 Destructive testing

Critical containment works require destructive seam sampling per design and specification. Tests typically cover peel performance, shear performance and seam strength. Sample locations must be numbered and logged. Holes left by sampling are repaired with certified HDPE patches and re-tested non-destructively.

10. Step 7 — Repair and Final Acceptance

Typical defects found in testing: skipped weld · cold weld · discontinuous seam · localized burn-through · insufficient seam width · mechanical damage · holes · through-defects.

After repair, do not rely on visual inspection alone — re-run the appropriate non-destructive test for the defect type. Every repair must be logged with: defect number · repair location · repair time · repairer · test result.

The acceptance dossier

A complete HDPE geomembrane works file includes: design documents · material certificates · material test reports · incoming inspection records · subgrade acceptance records · deployment records · welding logs · trial-weld records · seam test records · destructive test reports · repair records · concealed-works acceptance records · as-built drawings · supervision documentation.

11. Step 8 — Protective Cover Construction

After welding, testing and acceptance, place the protective cover promptly per design. The cover protects the liner against: mechanical damage · foot traffic · puncture by sharp particles · long-term UV exposure · temperature cycling.

Cover material must meet the specification and contain no sharp stones, metal or roots. When backfilling over the liner, never allow heavy machinery to track directly on unprotected membrane. Cover thickness, material type and placement method follow the project design.

12. HDPE Geomembrane Installation QA Checklist

StageKey ItemsControl Focus
PreparationDrawings, materials, equipment, crewMethod statement and technical disclosure
SubgradeSmoothness, compaction, debrisNo sharp objects, no visible defects
DeploymentDirection, wrinkles, tensionNatural lay, no damage
OverlapsOverlap width, cleanlinessOverlap zone dry and clean
DetailsCorners, penetrations, anchoringReinforced, reliable connections
Trial weldsTemperature, speed, pressurePass before production welding
Production weldingSeam continuityPrevent skip, cold weld, burn-through
Non-destructive testingAir pressure, vacuum, sparkDefects marked and repaired immediately
Destructive testingPeel, shearSample per design and specification
RepairPatches, extrusion weldsRe-test after every repair
Final acceptanceDocuments, records, test dataComplete and traceable
Protective coverBackfill material, machineryPrevent secondary liner damage

13. Five Most Common HDPE Geomembrane Installation Failures

Failure 1 — Poor subgrade preparation

Sharp stones, concrete rubble or hollow zones left under the liner create local stress concentration and eventual puncture. Fix: complete formal subgrade acceptance before any panel goes down.

Failure 2 — Laying the liner too tight

HDPE is a thermoplastic — temperature swings drive dimensional change. Forced tension during deployment adds thermal stress that comes back as wrinkles and seam distress. Fix: control lay condition for the site temperature; keep appropriate slack.

Failure 3 — Welding parameters not adjusted to site conditions

The same welder cannot run identical parameters across different temperature, wind and membrane states. Fix: trial weld before production; re-trial whenever conditions change materially.

Failure 4 — Oversimplified details

Penetrations, corners and anchorage zones are structurally complex and quality-critical. Fix: detail design in advance; use reinforcement patches, purpose-made boots and other designed connections.

Failure 5 — Visual inspection only, no systematic testing

Eye inspection cannot find every latent defect. Fix: apply air pressure, vacuum and spark testing per the works requirements, plus necessary destructive testing.

14. Installation Quality and Production Quality Are Equally Important

An HDPE geomembrane serves for decades. Its final performance depends not only on site workmanship but on how the liner itself was produced: raw materials, formulation, extrusion stability, thickness control, width control and online inspection.

For liner manufacturers, a stable extrusion system must control: HDPE resin conveying · dosing and blending · melting and plasticization · melt homogenization · extrusion pressure · melt temperature · filtration · die flow channel · sheet thickness · sheet width · cooling and forming · haul-off · online thickness gauging · winding.

For wide-width HDPE geomembrane, line design must additionally address throughput, gauge uniformity, transverse thickness control, melt stability and long-run continuous production capability. A geomembrane line is not simply "resin squeezed into a sheet" — it is a complete production system spanning dosing, extrusion, forming, cooling, haul-off, gauging and winding.

15. The HDPE Geomembrane Extrusion Line: From Resin to Finished Liner

A typical HDPE geomembrane line runs:

Resin conveying → gravimetric dosing → extrusion & plasticization → melt filtration → T-die forming → calendering & cooling → online thickness gauging → haul-off → automatic edge trimming → automatic winding

Depending on product specification, the line can be configured with automatic dosing, melt filtration, online gauging, automatic centering, edge-material handling and automated winding systems.

Line design is customized around: HDPE resin type · virgin/virgin-plus-regrind strategy · product thickness · product width · target output · multilayer requirements · surface texture requirements · automation level · online quality inspection requirements.

Landfill liners, tailings liners, aquaculture liners and industrial containment liners differ substantially in final specification — no single configuration fits all products.

FAQ — HDPE Geomembrane Installation

What are the main steps of HDPE geomembrane installation?

Eight sequential steps: preparation, subgrade treatment, deployment, detail and anchoring, thermal fusion welding, seam testing and repair, final acceptance, and protective cover construction. Each step is inspected and accepted before the next begins.

Why is trial welding required before production welding?

Trial welding locks in the correct temperature, speed and pressure for the actual membrane thickness, resin, ambient conditions and welder model. Parameters cannot be set once and forgotten — re-trial when conditions change.

How are HDPE geomembrane seams tested?

Air pressure testing of the double-track wedge channel, vacuum box testing of extrusion welds and patches, spark testing where specified, plus destructive peel/shear sampling on critical works — with sampled holes patched and re-tested.

What weather should be avoided?

High wind, rain or snow, wet membrane surfaces, and temperature extremes. Ballast deployed panels against wind uplift.

Tight or slack deployment?

Natural, flat, with controlled slack. HDPE is thermoplastic — forced tension adds thermal stress that returns as wrinkles and seam problems.

Which standards govern HDPE geomembrane?

China: GB/T 17643-2025 for the product, plus project design and applicable sector codes. International projects commonly reference GRI-GM13, GRI-GM19 and ASTM D6392. The governing project specification always takes precedence.

16. Conclusion: A Successful Liner System Needs "Material + Production + Installation" Working Together

HDPE geomembrane containment is a systems engineering exercise. From resin selection and liner production, through subgrade preparation, deployment, fusion welding and detail treatment, to seam testing and protective cover — every link affects the reliability of the final barrier.

A complete HDPE geomembrane solution is therefore:

Stable HDPE geomembrane extrusion line + sound liner design + standardized installation + systematic seam testing.

Companies planning an HDPE geomembrane production line should configure it against target thickness, width, output, resin system and end application. Changzhou Jwell Plate and Sheet Equipment Technology provides technical proposals for HDPE geomembrane extrusion lines — extrusion system, die, forming and cooling, haul-off, online thickness control and winding — matched to your target gauge, width, throughput and application.

Contact us to discuss your HDPE geomembrane line specification →
